Ask any brand owner what they want to know before signing with a manufacturer, and the timeline usually comes up first. When can I start selling? It’s a fair question. Launch dates, ad campaigns, retailer meetings and cash flow all hang on the answer.

That’s why the aerosol contract manufacturing lead time matters so much. Whether you’re launching an air freshener, a car care spray, an insecticide or a personal care product, knowing how long each step takes lets you plan properly and avoid nasty surprises.

Below, we walk through the process step by step, look at what speeds it up or slows it down, and share a few ways to keep your project moving.



What Do We Mean by Lead Time?

Lead time is simply the time between giving the green light on your project and having finished, packed products ready to ship. It covers formulation, samples, testing, sourcing components, filling, quality checks and packing.

At Alqaed Factory, a new aerosol product usually takes 6 to 8 weeks from the first brief to the first commercial delivery. Simple products using standard components, packaging and an already-approved formulation can move faster than that. Fully custom products, on the other hand, can take longer.

If you’re reordering a product we’ve already made, with no changes to the formulation, artwork or packaging, it’s much quicker: usually 3 to 5 weeks, depending mainly on material and component availability and our production schedule.

One thing worth knowing before we go further: several of the steps below happen at the same time rather than one after another. So the individual timings don’t simply add up to the total. We’ll explain how that works as we go.

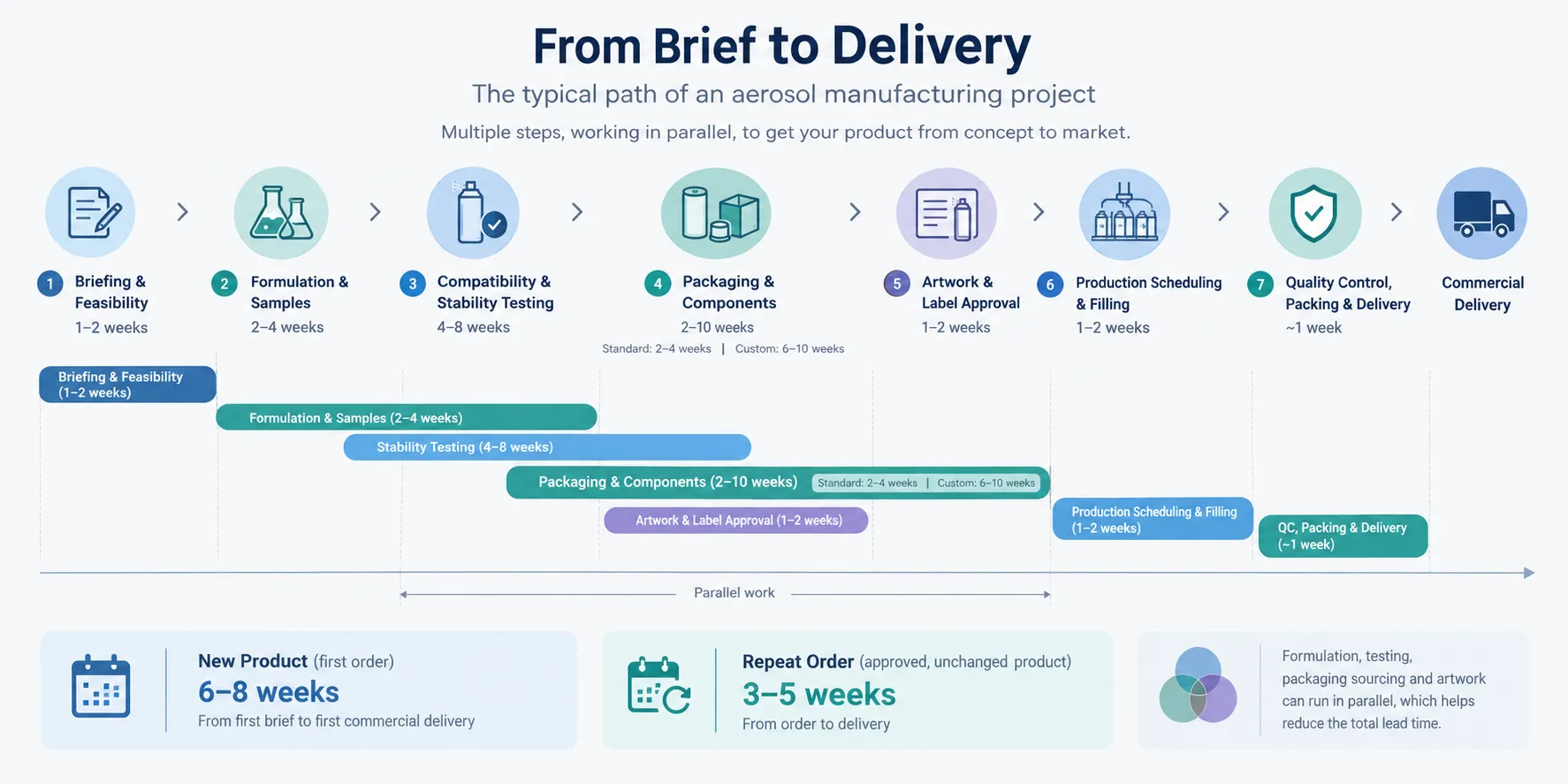

Infographic showing the stages of aerosol manufacturing from brief to delivery

The Process, Step by Step

1. Briefing and feasibility (1–2 weeks)

Everything starts with a conversation. You tell us what you want to make, who it’s for, the scent or performance you’re after, the packaging you have in mind and roughly how many units you need. We look at what’s feasible, suggest formulations and can sizes, and send you a first quotation.

Simple projects using an existing formulation and standard packaging are usually reviewed faster than this.

2. Formulation and samples (2–4 weeks)

If you don’t have a formula yet, our technical team builds one around your brief, choosing the concentrate, propellant, solvents and fragrance. Then we prepare samples for you to test.

How long this takes depends on how complex the product is, whether the raw materials are readily available, and how many rounds of feedback you need. Our standard process includes two rounds of sampling. If you want significant changes after that, such as a different fragrance direction or a new formulation approach, extra rounds can be arranged, though they usually come with additional time and cost.

3. Compatibility and stability testing (4–8 weeks)

An aerosol is a pressurized product, so this step matters. We check how the formula behaves with the can and its internal coating, along with pressure, spray rate, valve performance, leakage and corrosion.

This initial evaluation typically takes 4 to 8 weeks, and longer-term stability testing can continue beyond that depending on the product and the requirements of your target market. Water-based formulas and chemically corrosive products tend to need more time here, since they interact more with the can lining.

It’s tempting to hurry through testing, but that’s how you end up with leaking cans or clogged valves after launch. It’s worth doing properly.

Aerosol cans, valves and actuators used in contract manufacturing

4. Packaging and components (2–10 weeks)

This is often the longest and least predictable part, and it varies a lot depending on what you choose.

Standard cans and readily available components usually take 2 to 4 weeks. Custom packaging, such as your own printed cans, a specific valve, actuator, cap or other imported parts, typically takes 6 to 10 weeks, since it depends on supplier stock, printing schedules, shipping method and country of origin.

If speed is a priority, sticking with standard can sizes and stock components is by far the easiest way to save time.

5. Artwork and label approval (1–2 weeks)

Your label needs the right warnings, hazard information, volume, manufacturer details and any market-specific requirements, and preparing the design, reviewing it, making revisions and getting your final sign-off usually takes 1 to 2 weeks.

This step almost always runs alongside formulation, testing and packaging sourcing, so it rarely adds extra time to the overall project on its own.

6. Production scheduling and filling (1–2 weeks)

Once the formulation and artwork are fully approved, and every raw material and packaging component has arrived at the factory, your order moves into scheduling, batching and the actual filling run. This stage takes 1 to 2 weeks.

7. Quality control, packing and delivery (about 1 week)

Before anything leaves the factory, we check fill weight, run leak tests, check spray performance and confirm everything meets spec. Products are then packed and palletized, which takes around a week in total.

Once QC is signed off, delivery within the UAE is usually quick. Export orders take longer, since they involve documentation, freight booking and customs clearance, and the exact time depends on the destination country and shipping method.

Finished aerosol products packed on pallets ready for shipment from the UAE

Why the Numbers Above Don’t Just Add Up

If you add every stage together, you’ll get a much bigger number than the 6 to 8 weeks we mentioned earlier, and that’s expected. Artwork design, formulation development, stability testing and packaging sourcing usually run at the same time rather than one after the other. So the real project timeline is closer to whichever of those parallel stages takes the longest, not the sum of all of them.

This is also why giving us your packaging preferences and brief details as early as possible actually matters. The sooner sourcing and artwork can start, the more they overlap with formulation and testing, and the less they add to your overall timeline.



What Affects Your Lead Time

Not every project runs at the same speed. These are the things that make the biggest difference:

How to Get Your Products Faster

You can’t control every step, but a few habits help a lot:

  1. Write a detailed brief. Volumes, fragrance references, can size and packaging ideas from day one.
  2. Use standard components where you can. They can save weeks compared with custom packaging.
  3. Pick one decision-maker. Samples and artwork shouldn’t sit in someone’s inbox for two weeks.
  4. Share packaging and artwork direction early. The sooner sourcing and design start, the more they overlap with formulation and testing.
  5. Plan ahead if you need custom packaging. Six to ten weeks is a long runway, so start that conversation as early as possible.
  6. Keep some buffer stock. It saves you from rushed reorders later.

Al Qaed Factory team discussing an aerosol product project with a client

Why Making Your Aerosols in the UAE Helps

A local manufacturer means shorter communication loops, easy factory visits and quick delivery within the country. If you’re selling across the Middle East, Africa or Asia, the UAE’s ports and shipping connections make distribution simpler too.

It also helps when one partner handles formulation, filling and packaging under the same roof. Fewer handoffs between suppliers means fewer places for things to get stuck.



Frequently Asked Questions

How long does aerosol contract manufacturing take in the UAE?

For a new product, expect around 6 to 8 weeks from the first brief to the first commercial delivery. Simple products using standard components can be faster, and fully custom products can take longer. Repeat orders of an approved product usually take 3 to 5 weeks.

Why don’t the individual stage timings add up to the total?

Because several stages, including artwork, formulation, testing and packaging sourcing, run in parallel rather than one after another. The overall timeline is closer to the longest of these parallel stages, not the sum of all of them.

Which step takes the longest?

Packaging and components, if you need custom printed cans or specific parts. Standard packaging takes 2 to 4 weeks, while custom packaging can take 6 to 10 weeks depending on the supplier and printing schedule.

Can I speed things up?

Yes, to a point. A clear brief, quick approvals, standard packaging, and sharing your artwork and packaging preferences early all help, since they let more stages overlap. Custom packaging timelines are harder to compress, so plan for those early.

Do I need my own formula?

No. If you don’t have one, our team can develop it for you, which usually takes 2 to 4 weeks. If you already have an approved formula and are using standard packaging, your project can move noticeably faster.

What’s the minimum order quantity?

For standard cans and packaging, our MOQ is 100 cartons per SKU. For custom-printed cans or fully bespoke packaging, MOQ depends on the printing requirements and our packaging supplier’s own minimums, and we’ll confirm it as part of your quotation.

How many sample rounds do I get?

Our standard process includes two rounds of sampling. If you need major changes after that, such as a different fragrance or formulation direction, additional rounds can be arranged, usually with some extra time and cost.

Why does testing take so long, and can it vary?

Because aerosols are pressurized, every formula needs checking for pressure, spray rate, valve performance, leakage, corrosion and compatibility with the can lining. This usually takes 4 to 8 weeks, though water-based or more corrosive formulas can need longer, and longer-term stability testing may continue beyond the initial evaluation.

Can you handle export orders?

Yes. Export timelines depend on documentation, freight booking, customs procedures and the destination country, so the delivery time will be longer than local UAE delivery. Let us know your target markets early so we can plan accordingly.

How do I find out the timeline for my specific product?

Send us your idea, expected volumes and packaging preferences. Since so much depends on the product itself, we’ll review your brief and come back with a realistic schedule rather than a generic estimate.



So, How Long Will Yours Take?

For most new products, you’re looking at roughly 6 to 8 weeks, and repeat orders come together in 3 to 5. Where your project lands in that range comes down to three things: whether you’re using standard or custom packaging, how much testing your formula needs, and how quickly approvals come back to us. Get those moving early, and the rest tends to fall into place.
